Program
Receipts

What was promised.
What was funded. What followed.

Program record 003 U.S. Air Force · Acquisition accountability

LGM-35A Sentinel

Real progress. A program still being reset.

The original commitment was initial operational capability in June 2029. The Air Force now targets an initial capability in the early 2030s. Between those positions came a critical cost breach, a decision to continue the program and the withdrawal of its development approval. A replacement cost-and-schedule baseline is not established by the records reviewed for this edition. N01 · p. 11, N02, N03 · pp. 91–92, N04

There are tangible results: construction starts and, reported September 14, 2026, a completed inert missile assembly and a design review specifically for first flight. But those receipts are not a flown missile, an operational declaration or proof that the reset has solved the program's cost and schedule problems. N05

Then 2020 baseline

June 2029

Original initial operational capability objective; June 2030 threshold.

Inspect the commitment ↓

Target 2026 reporting

Early 2030s

An initial-capability target, not an achieved IOC or exact replacement date.

Read the latest statement ↗

Reported September 2026

Inert assembly

A real ground milestone. Flight testing and operational capability remain future work.

Inspect the results ↓

Edition 1.0 · Reviewed September 24, 2026 · Evidence cutoff 06:55:44 EDT / 10:55:44 UTC. Selected public acquisition records, not live status. The original baseline, historical estimates, newer targets and reported outcomes retain their own dates.

01 / Program record

The original promise survives the reset

Sentinel, formerly Ground Based Strategic Deterrent (GBSD), is a replacement program for the Minuteman III system and its supporting infrastructure—not simply a purchase of missile bodies. The September 2020 acquisition baseline preserved in the MSAR planned 659 end items: 25 development and 634 procurement. That accounting quantity is not a count of deployed or operational missiles. N01 · p. 13

Original schedule and later targets
Milestone 2020 objective / threshold Pre-review forecast Latest reviewed position
System critical design review Jul 2023 / Jul 2024 May 2024 (not current) New full-system date not established in this edition. The September 2026 review was specific to first flight. N01 N03 N05
Milestone C / low-rate production decision May 2026 / May 2027 Jan 2026 (not current) TBD in GAO's rebaseline assessment; no achieved production decision established here. N01 N03
Initial operational capability Jun 2029 / Jun 2030 May 2029 (not current) Early-2030s initial-capability target; no exact replacement date or IOC declaration established here. N01 N04 N05
Full-rate production decision Sep 2029 / Sep 2030 Jul 2029 (not current) TBD in GAO's rebaseline assessment; not inferred from early-2030s initial capability. N01 N03

The original objective and threshold are different. So is the MSAR's May 2029 forecast: it was an estimate, not the original June 2029 commitment. The report explicitly says its schedule estimates were under review. This edition does not promote those stale estimates into a current schedule or assign an exact month to “early 2030s.” Nor does it equate that announced initial-capability target with a documented, unchanged definition of formal IOC. N01 · p. 11, N04, N05

The Air Force notified Congress of a critical unit-cost breach on January 18, 2024. In July, DoD certified that the program met the criteria to continue, rescinded Milestone B and directed restructuring. These were consequential management decisions, not operational milestones. In February 2026 the Air Force targeted a new Milestone B decision by year-end; GAO's July publication still described evolving estimates. A subsequently signed replacement baseline was not established in this review. N02, N03 · p. 92, N04

A date discrepancy is retained, not silently repaired. The MSAR's history gives September 4, 2020 for Milestone B, its schedule table records September 1, and GAO uses a September 15 development-start reference for its practices assessment. The baseline table is explicitly dated September 4; the timeline uses September 2020. None of these day labels changes the June 2029 original IOC objective. N01 · pp. 9, 11, N03 · p. 91

“First flight” changed scope

First-flight scope comparison
Reference Date / scope Interpretation
Earlier plan March 2028 · silo-based first flight Historical plan retained by February GAO snapshot. N12 N03
Revised early test 2027 · pad-based flight Changed initial scope; not the same test brought forward. N03
Revised silo-based test Q3 FY2030 · April–June 2030 Silo-based first-flight target; not an operational declaration. N03

GAO's February snapshot preserved a March 2028 first-flight plan. Its later annual assessment explains that the revised 2027 plan uses an above-ground launch pad with a reduced initial test scope; the first silo-based flight is instead targeted for Q3 FY2030 (April–June 2030). These are not like-for-like dates for the same test. Earlier learning may be useful, but moving one event forward is not proof that the original full-system milestone has recovered. The September announcement still described flight testing as future work. N12 · p. 1, N03 · p. 92, N05

02 / Program record

A dated program history

Actual entries identify what was reported: an award, a decision, a construction start or a test-related event. Publication dates are labeled where the precise event day is unavailable. A publication containing a forecast is not an achieved forecast.

  1. Sep 2020Baseline

    Original commitment

    Original development commitment

    The September 2020 baseline set June 2029 IOC and a June 2030 threshold. Month precision avoids conflicting day fields in later reports. N01

  2. Sep 8, 2020Contract

    Reported event

    Development contract awarded

    $13.293562839bn award; $85m obligated at award. Neither is total lifetime program spending. N07

  3. Dec 11, 2023Reset

    Reported event

    Program deviation report signed

    Cost and schedule deviations were formally reported. The original baseline remained visible. N01

  4. Jan 18, 2024Reset

    Reported event

    Critical cost breach notified to Congress

    The notification triggered the review. Its initial percentages differ slightly from the later budget-index-adjusted figures. N01

  5. Jul 8, 2024Reset

    Reported event

    Continuation certified; Milestone B rescinded

    DoD announced the continuation decision and ordered restructuring. Certification was not delivery or approval of a final replacement baseline. N02

  6. Feb 17, 2026Plan

    Reported event

    Air Force publishes reset targets

    End-2026 Milestone B and early-2030s initial capability remain announced plans, not achieved milestones. N04

  7. Mar 27, 2026Construction

    Reported event

    Silo prototype groundbreaking reported

    Reported by this publication date; no exact groundbreaking day is assigned. Prototype work does not establish completed operational facilities. N09

  8. Jun 10, 2026Contract

    Reported event

    Training facility contract awarded

    $113.852388m award and reported obligation for a facility, not an operational missile. N08

  9. Jun 24, 2026Construction

    Reported event

    Utility-corridor pilot breaks ground

    Event reported in July; construction beginning is not network completion. N10

  10. Jul 2, 2026Oversight

    Reported event

    GAO explains the changed flight-test plan

    The 2027 pad-based target and FY2030 silo-based target are different test scopes. This is the report's publication date. N03

  11. Aug 17, 2026Construction

    Reported event

    Training-unit groundbreaking

    September 1 reporting describes an August 17 event and an early-2030s facility opening target. N11

  12. Sep 14, 2026Test

    Reported event

    Inert assembly milestone reported

    The Air Force reports completed inert vertical assembly and a first-flight-specific review. No flight or IOC is established by this receipt. N05

  13. End 2026Plan

    Forecast

    New Milestone B target

    A planned decision, not a signed decision established in this edition. N04

  14. 2027Test

    Forecast

    Pad-based first-flight target

    Different scope from the previously described silo-based first flight; not an achieved flight. N03

  15. FY2030 Q3Test

    Forecast

    Silo-based first-flight target

    April–June 2030 in the U.S. fiscal calendar; not the early-2030s initial-capability target. N03

  16. Early 2030sPlan

    Forecast

    Initial-capability target

    Broad planning window; do not assign a precise replacement IOC date or month-delay statistic. N05

03 / Program record

The cost increase that can be compared

The MSAR supplies a reproducible historical, same-dollar comparison: the September 2020 baseline of $77.7407 billion versus a $106.4269 billion pre-recertification estimate, both in constant FY2020 dollars and both covering 659 end items. That is $28.6862 billion, or 36.90%, higher. This is the PB2025 estimate in a report labeled December 2023—not a newly approved 2026 cost estimate. N01 · pp. 13, 16

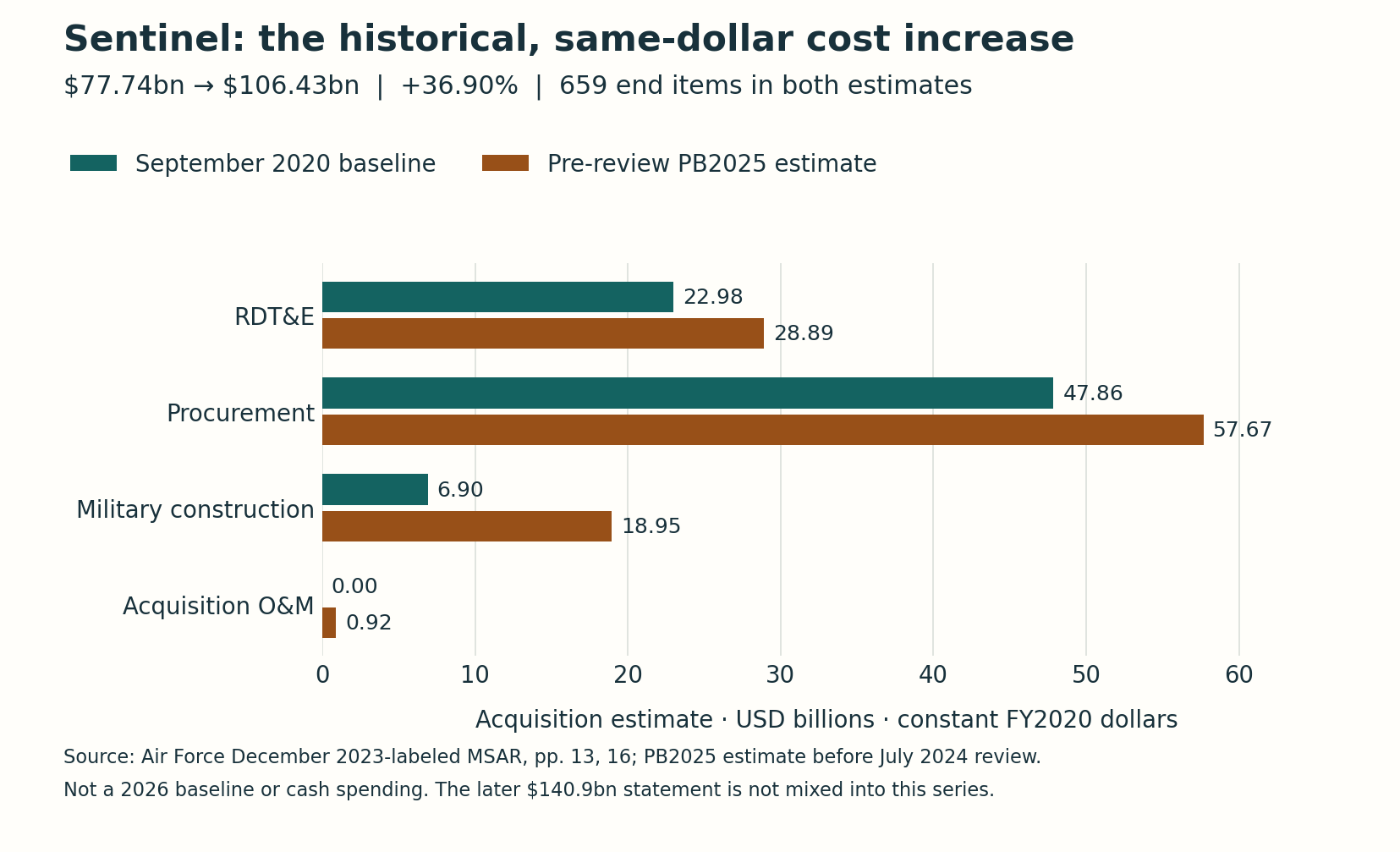

Historical same-dollar acquisition estimates: $77.74 billion baseline versus $106.43 billion pre-review estimate. Category values are repeated in the table below.
A historical comparison, not a 2026 cost estimate. Source: MSAR page 13. Chart PNG · SVG · CSV · Calculations
Historical estimates in constant FY2020 dollars
Category 2020 baseline ($m) Pre-review estimate ($m) Change ($m)
RDT&E 22,978.0 28,893.6 +5,915.6
Procurement 47,858.4 57,665.4 +9,807.0
Military construction 6,904.3 18,950.1 +12,045.8
Acquisition O&M 0.0 917.8 +917.8
Total · constant FY2020 dollars 77,740.7 106,426.9 +28,686.2 N01

Military construction accounts for about 42.0% of that historical increase: $12.0458 billion of $28.6862 billion. This is arithmetic from the four reported cost categories, not a causal attribution of overruns. The military-construction account also is not identical to the broader command-and-launch segment identified in the later review. Source values, units and calculations are available in the downloadable data. N01 · p. 13, N02

Why the later $140.9 billion is shown separately

The July 2024 announcement reported a $140.9 billion CAPE acquisition estimate for a modified program and described it as 81% above the previous Milestone B estimate. We preserve those as DoD's reported figures. The release does not explicitly state their dollar basis; this edition does not independently harmonize them with the MSAR's constant-2020 or then-year series. The MSAR's separate $152.413 billion then-year estimate therefore cannot be placed against $140.9 billion and labeled a saving. N02, N01 · p. 13

GAO's 2026 assessment marks its current cost row under review, and says the reliability of the preliminary reset estimates remains unclear until the process and new Milestone B are completed. Missing final estimates are not zero. All these numbers are acquisition estimates—not cash spent, a lifetime sustainment bill, or a price per deployed missile. N03 · pp. 91–92

Selected funding, with its stage attached

Selected RDT&E funding records
Fiscal year / scope USD million Stage Receipt
FY2025 · GBSD EMD. R-1 historical funding position; not cash disbursed. 1,942.400 Source-reported FY2025 Actuals (TOA) N06
FY2026 · GBSD EMD. Base-budget funding position shown in the April 2026 exhibit. 2,616.352 Discretionary enacted N06
FY2026 · GBSD EMD. Mandatory allocation component, not an obligation or outlay. 2,189.000 P.L.119-21 spend plan N06
FY2026 · GBSD EMD. Sum of the preceding two FY2026 components; do not add it to them again. 4,805.352 Displayed total N06
FY2027 · GBSD EMD. Proposed discretionary funding; not enacted funding or contract value. 4,521.370 Request N06

These rows cover only Air Force RDT&E account 3600F, PE 0605238F, GBSD EMD. The FY2026 displayed total is the sum of discretionary enacted funding and the P.L. 119-21 spend-plan component; it is not a third pot to add again. FY2025 “Actuals” is the budget exhibit's total-obligational-authority presentation, not a transaction-level outlay measure. FY2027 is a request. Military construction, other accounts and Minuteman III sustainment are not silently folded into this selected line. N06 · printed p. 42

The historical MSAR funding summary labels its full $152.413 billion estimated acquisition appropriations as appropriated to date, or 100%, while separately reporting $8.8989 billion of expenditures. That internally awkward summary is not used here as verified congressional funding completion or a reconciled cash ledger. The dated, account-specific records above support a narrower claim. N01 · pp. 13, 24

04 / Program record

Contracts are not the program's price tag

Selected contract actions
Date / action Award value ($m) Obligated at award ($m) Scope / source
Sep 8, 2020 · Northrop Grumman EMD award. FA8219-20-C-0006 13,293.562839 85 Cost-plus-incentive-fee. Development award, not total program cost; February 2029 was the award's completion estimate, not IOC. N07
Jun 10, 2026 · Korte Construction formal training unit. W912PL-26-C-A005 113.852388 113.852388 Firm-fixed-price. Facility construction. Later Air Force reporting places facility opening in the early 2030s; scope/dates are not reconciled here. N08

The $13.293562839 billion development award and its $85 million initial obligation describe different stages of the same action. The original contract was cost-plus-incentive-fee, not a fixed-price guarantee that development could never cost more. The later MSAR lists a historical $13.3163 billion target and different contractor/program-manager estimates at completion while warning that replanning limited the earned-value figures. None is another purchase to add to the initial award. No current aggregate contract balance is asserted here. N07, N01 · pp. 21–22

The 2026 $113.852388 million training-facility award illustrates a separate construction commitment with the same amount reported obligated at award. It uses FY2025 funds despite the June 2026 award date. Its March 6, 2029 estimated contract completion differs from the Air Force's later early-2030s facility opening target. Construction completion and operational opening may cover different work; the reviewed evidence does not reconcile the dates or establish a contract extension. N08, N11

These are selected actions, not all prime contracts, modifications, subcontracts or obligations. They are not summed into a total-program spending claim.

05 / Program record

What has actually happened

Reported outcomes and their limits
Observation / date What the evidence supports What it does not establish
Prototype construction · Mar 27, 2026 Silo-prototype groundbreaking reported by the Air Force. N09 Not a completed silo, completed force or verified cost saving.
Utility-corridor pilot · Jun 24, 2026 Groundbreaking reported for the construction pilot. N10 Not a completed operational communications network.
Formal training unit · Aug 17, 2026 Groundbreaking documented; contractor named in the official release. N11 Not an opened facility or trained force; opening remains forecast.
Inert integration · Sep 14, 2026 Completed inert assembly and first-flight-specific design review reported by this publication date. N05 Not a flight, full-system operational evaluation, or initial operational capability.

The distinction is not “nothing has happened.” Documented development and construction work are real results. The question is which promise each receipt can close. An inert article assembled on a test pad does not close a flight-test or operational-capability commitment. A first-flight-specific design review does not establish that the entire system's original critical design review is complete. A groundbreaking does not close a facility-delivery commitment. N03, N05, N09, N10, N11

These are agency-reported events. Program Receipts has not independently observed the tests or certified effectiveness, nuclear readiness or the eventual completion cost.

06 / Program record

What would close the open questions

For a later edition, the most informative receipts would be:

  1. A signed replacement baseline: approved cost, price basis, quantity, scope and schedule—not another broad target.
  2. A flight-test result with its scope identified: distinguish pad-based development testing from the later silo-based event and operational evaluation.
  3. A defined initial-capability declaration: specify what was delivered and accepted, not just a date window.
  4. A reconciled funding trail: account-specific appropriations, obligations and outlays without overlapping totals or estimates.
  5. A credible transition record: align Sentinel fielding with continued Minuteman III support. GAO identified transition-planning risks; that is not a finding in this edition that an actual readiness gap has occurred. N12 · p. 2

Bottom line: the selected record supports real progress and continuing uncertainty at the same time. The original June 2029 commitment remains the reference; the reset is not itself delivery, and the reviewed evidence cannot yet settle the final price or date. N01, N02, N03, N05

07 / Program record

How to read this edition

This is a finite public-record research edition, not comprehensive monitoring. Cost calculations use the explicitly labeled historical constant-FY2020 series; the newer unharmonized estimate is kept separate. Funding units were converted from thousands to millions without changing fiscal stage. No precise slip is calculated from an “early 2030s” range. Unknown current quantities, obligations, outlays and achieved IOC remain null in the data.

The official MSAR and GAO annual report were re-reviewed from hash-checked September 12 receipts after fresh access failed. The R-1 was freshly downloaded; official web articles were reviewed through indexed full-article retrieval where direct access was blocked. A source hash identifies a version, not its truth. Research, writing and verification were performed with AI assistance; arithmetic, source-table, link, browser and print checks are not independent human peer review.

All substantive content and references are available without JavaScript. Optional timeline filters change only what is displayed; printing restores all events. Downloads include the full report, a short brief, chart, typed data, calculation script and source register. See the collection methods for financial and outcome definitions.

08 / Program record

Source appendix

N01 · U.S. Air Force / DoD

LGM-35A Sentinel Modernized Selected Acquisition Report, December 31, 2023

Document label: Dec 31, 2023 · Reviewed 2026-09-24

PDF/printed pp. 8–11: breach history and original schedule; p. 13: constant-2020 and then-year acquisition estimates; pp. 16–17: unit-cost changes and revised indices; p. 21: EMD contract; p. 24: funding-summary inconsistency. The FY2025 budget report includes 2024 events despite its December 2023 label.

Reused the hash-checked official PDF retrieved September 12, 2026; fresh direct access returned 403. Schedule, cost, contract and expenditure tables inspected visually. This is a historical pre-recertification estimate, not the 2026 baseline.

Open original source ↗

Back to: Promise · Money · Contracts · Limits · Method

N02 · DoD News / U.S. Air Force

Department of Defense announces results of Sentinel Nunn-McCurdy Review

Document label: Jul 8, 2024 · Reviewed 2026-09-24

Paragraphs on January 18 notification, certification, rescinded Milestone B, $140.9bn / 81% reported comparison, command-and-launch cost growth and estimated delay.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. The release does not explicitly label the dollar basis of its $140.9bn figure.

Open original source ↗

Back to: Promise · Money · Limits

N03 · U.S. Government Accountability Office

Weapon Systems Annual Assessment — GAO-26-108457

Document label: Jul 2, 2026 · Reviewed 2026-09-24

PDF pp. 103–104 / printed pp. 91–92, Sentinel assessment. January 2026 interim status; current cost row under review; altered first-flight scope, 2027 pad-based tests and Q3 FY2030 silo-based test; unresolved rebaseline and program-office targets.

Reused the hash-checked official PDF retrieved September 12; fresh direct PDF access failed. Both Sentinel pages were visually reviewed. July publication does not make its January assessment a September observation.

Open original source ↗

Back to: Promise · Money · Limits · Method

N04 · Secretary of the Air Force Public Affairs

Delivering deterrence: Sentinel restructure to complete in 2026; initial capability timeline set

Document label: Feb 17, 2026 · Reviewed 2026-09-24

Opening and program-restructure paragraphs: new Milestone B targeted by end-2026; initial capability early 2030s. Progress bullets: ground-test article and component tests; not an operational declaration.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed.

Open original source ↗

Back to: Promise · Limits

N05 · Secretary of the Air Force Public Affairs / Wright-Patterson AFB

Air Force assembles inert Sentinel missile, moving with pace toward flight testing

Document label: Sep 14, 2026 · Reviewed 2026-09-24

Opening, first-flight design-review paragraph and final paragraph: inert vertical assembly after a four-month campaign, first-flight-specific review, planned 2027 flight testing and early-2030s initial capability.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. September 14 is publication; an exact assembly-completion date is not assigned.

Open original source ↗

Back to: Outcomes · Limits · Method

N06 · Office of the Under Secretary of Defense (Comptroller)

FY2027 RDT&E Programs (R-1)

Document label: Apr 2026 · Reviewed 2026-09-24

PDF p. 47 / printed p. 42: 3600F, line 102, PE 0605238F, Ground Based Strategic Deterrent EMD. FY2025 Actuals; FY2026 discretionary enacted / P.L.119-21 spend plan / total; FY2027 discretionary request. All values in $thousands.

Fresh direct PDF retrieval succeeded September 24. Column labels and the entire line were visually inspected. This is a total-obligational-authority exhibit, not an outlay ledger.

Open original source ↗

Back to: Money · Limits

N07 · U.S. Department of Defense (historical release hosted on war.gov)

Contracts for September 8, 2020

Document label: Sep 8, 2020 · Reviewed 2026-09-24

AIR FORCE, first paragraph: FA8219-20-C-0006, $13,293,562,839 cost-plus-incentive-fee award, $85m FY2020 RDT&E obligation, one offer and February 2029 estimated completion.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. Historical award terms, not the current contract balance.

Open original source ↗

Back to: Contracts · Limits

N08 · U.S. Department of War

Contracts for June 10, 2026

Document label: Jun 10, 2026 · Reviewed 2026-09-24

ARMY, Korte Construction paragraph: W912PL-26-C-A005, $113,852,388 firm-fixed-price FTU construction contract; same FY2025 MILCON defense-wide obligation; March 6, 2029 estimated completion.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. The funding fiscal year is not the award year; completion is a forecast.

Open original source ↗

Back to: Contracts · Limits

N09 · Secretary of the Air Force Public Affairs

Sentinel Program advances with silo prototype

Document label: Mar 27, 2026 · Reviewed 2026-09-24

Opening and prototype-purpose paragraphs: groundbreaking for a full-scale silo prototype; new-silo approach rather than refurbishment; anticipated construction learning.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. A prototype groundbreaking is not completed infrastructure or demonstrated cost savings.

Open original source ↗

Back to: Outcomes

N10 · 90th Missile Wing Public Affairs / Air Force Global Strike Command

Sentinel utility corridor project commences with groundbreaking event

Document label: Jul 23, 2026 · Reviewed 2026-09-24

Opening and photo captions: June 24, 2026 groundbreaking for utility-corridor pilot. July 23 is this mirror's publication label; other official mirrors list July 22.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. Reports construction beginning, not a completed network.

Open original source ↗

Back to: Outcomes

N11 · Air Force Nuclear Weapons Center / Staff Sgt. An Pham

Officials break ground on AETC's Sentinel training unit at Vandenberg SFB

Document label: Sep 1, 2026 · Reviewed 2026-09-24

Opening: August 17 groundbreaking. Closing facility paragraph: opening slated for early 2030s. This is not the March 2029 contract completion forecast in N08.

Reviewed the official publisher's indexed full article through web retrieval on September 24, 2026. Direct HTTPS retrieval was blocked; no successful raw-file download is claimed. No source reviewed reconciles contract completion with operational opening; do not treat them as equivalent dates.

Open original source ↗

Back to: Contracts · Outcomes · Method

N12 · U.S. Government Accountability Office

Intercontinental Ballistic Missile Modernization Faces Critical Risks and Opportunities — GAO-26-108755

Document label: Feb 18, 2026 · Reviewed 2026-09-24

PDF p. 1: rescinded Milestone B and baselines, at-least-$141bn uncertain estimate, prior March 2028 first-flight plan. P. 2: transition risk-management and extended Minuteman III sustainment findings.

Official PDF text reviewed through web retrieval; direct PDF download and screenshots failed. Earlier first-flight scope is clarified by the later annual assessment N03.

Open original source ↗

Back to: Promise · Limits

09 / Program record

Edition history

September 24, 2026 · Sentinel edition 1.0. First complete Sentinel report, preserving the 2020 commitment, pre-review cost comparison, 2024 reset, selected funding/contracts and reported 2026 results through the stated cutoff. Adds a short brief and reproducible chart/data. No MQ-25 or KC-46A factual re-review is implied; their September 12 cutoffs remain unchanged.

LGM-35A Sentinel · Edition 1.0 · Evidence cutoff 2026-09-24 10:55:44 UTC.
Read another record: MQ-25 · KC-46A · Sentinel · All records
